Backlog and prioritization

Ship the small useful version first, and learn before you build the rest.

Once a team has chosen a solution, the next decision is how to deliver it. Shorter Loop lets you split each solution into versions such as Pilot, Prove, Expand and Mature, then put versions from different solutions together into releases.

Each release carries its own plan, runbook and communication plan. Each version stays linked to the solution, opportunity and objective it serves.

This page uses an anonymized customer example. The backlog scores, assumptions and decisions can be inspected in the demo.

A prioritization score is only as reliable as the assumptions used to create it.

The problem

Teams work in sprints, and customers still get the solution in one large batch.

Almost every software team plans in two-week sprints. Sprints make the engineering work iterative. Delivery to customers usually stays a single event: finished stories pile up until the whole solution is ready, and the first real customer feedback arrives after the last feature ships.

  • THE PLANEvery epic and feature for the solution goes into one delivery plan.
  • THE SPRINTSEach sprint finishes stories and demos them internally. None of it reaches customers yet.
  • THE LAUNCHEverything ships together, along with any parts customers didn't need.
  • THE LEARNINGThe team finds out what worked only after the budget is spent.

Delivery tools reinforce this. In Jira, a version is defined as a set of features released together, so it ends up as a date bucket for whatever is ready. Nothing in it describes what the smallest useful slice of a solution is, or what should come next.

Two separate decisions

What goes into each version of a solution, and when versions go out, are separate decisions.

A version is a decision about scope. It answers what the smallest useful slice of one solution is and what the next version is meant to learn or add. A release is a decision about timing and coordination. It answers which versions, from which solutions, go to customers together, and how.

When one field holds both decisions, scope follows the calendar. Whatever is finished by the release date ships, and the question of what customers needed first never gets asked.

VERSION
RELEASE
Belongs to one solution
Spans many solutions
Answers "what is enough to learn from?"
Answers "what goes out together, and when?"
Pilot, Prove, Expand, Mature, or names your team chooses
A named release with a date
Owned by the product team
Coordinated with engineering, support and marketing

What the research says

The bigger the batch, the bigger the miss. Learn early and cheaply.

Large software projects overrun, and a meaningful share overrun catastrophically. The risk grows with every month a project runs before anyone checks it. An epic shipped in one piece follows the same pattern at a smaller scale. The cheapest check is to ship a small part of the solution and watch what customers do.

What it costs the team

A big launch puts months of work on one day, and the team carries the risk.

In our experience, the cost of big-batch delivery shows up long before the budget review.

Sprint reviews stand in for customer feedback

Stakeholders see progress every two weeks. Customers see nothing for months, so the team keeps building on its first guess.

Finished work waits for unfinished work

Engineers complete parts that customers could use today, then hold them until the rest of the solution is done.

Launch day lands on everyone

Support, sales and marketing learn the details late. A problem in one part can hold back the whole release.

Work nobody needed stays in the product

Parts that would have been dropped after an early version stay in the product, and engineering maintains them.

A better way to deliver

Plan each solution in versions, and assemble releases from whatever is ready.

Keep your sprints. Add the part sprints leave out: small releases that put each slice of a solution in customers' hands, so the next sprint can use what they did with it.

01

Slice the solution into versions

Use a story map, or another way of slicing, to decide what the Pilot must include, what the Prove version needs to test, what belongs in Expand, and what a Mature version would need.

02

Build the first version

Only the epics and features in the Pilot go to engineering first.


03

Release it with others

Group the versions that are ready, across solutions, into one release with a plan.


04

Learn from customers

See what customers do with the version before committing to the next one.


05

Adjust the next version

Move features between versions, drop them, or add new ones based on what you learned.


How Shorter Loop does it

Versions belong to solutions. Releases pull versions from any solution.

Each solution in Shorter Loop has its own backlog of epics and features. You split that backlog into versions. Separately, you build releases by picking versions from any number of solutions.


Story maps for slicing

Lay out a solution's features along the customer's journey, then draw lines across the map to cut versions. A story map won't suit every backlog, but it gives most teams a clear first slice.

Versions of a solution

Move each epic and feature into a version: MVP, MVP+1, delightful, or names your team chooses.

Many solutions in flight

Work on versions of several solutions at the same time. Each one keeps its own sequence.

Releases decoupled from versions

A release can hold version 1 of one solution and version 3.5 of another. Changing a release date doesn't change what's in a version.

Release plan, runbook and communication plan

Each release carries the plan for getting it out, the runbook for the day, and what you'll tell customers and the rest of the company.

Linked to the reason for building

Every version stays connected to its solution, the opportunity it addresses and the objective above that.

Shorter Loop does not replace Jira or your sprint tool. Day-to-day delivery status comes from the tracker through the integration, so it stays current only while that integration is connected.


SolutionPilotProveExpandMature
Solution AIn release 1PlannedLaterLater
Solution BShippedIn release 1PlannedLater
Solution CIn progressPlannedLaterLater

Release 1 takes the Pilot of solution A and Prove version of solution B. Solution C's Pilot isn't ready, so it waits for a later release without holding the others back.


Customer story Solveo · two versions of one solution

From a validated pilot to the next bet, one version at a time.

In the Strategize example, Solveo picked its solution: let the AI auto-send answers based on how complex a ticket is. The team split that solution into versions and shipped the first one to twelve pilot accounts. Every step below happened in Shorter Loop.

CompanySolutionPilot accountsReleases so far
B2B customer-support platformAuto-send by complexity122

STEP 01

Split the solution into versions, each with its bet

The team cut the solution into four versions and wrote down what each one had to prove before anyone started building. The fourth still has no hypothesis, and Shorter Loop says so on the card.

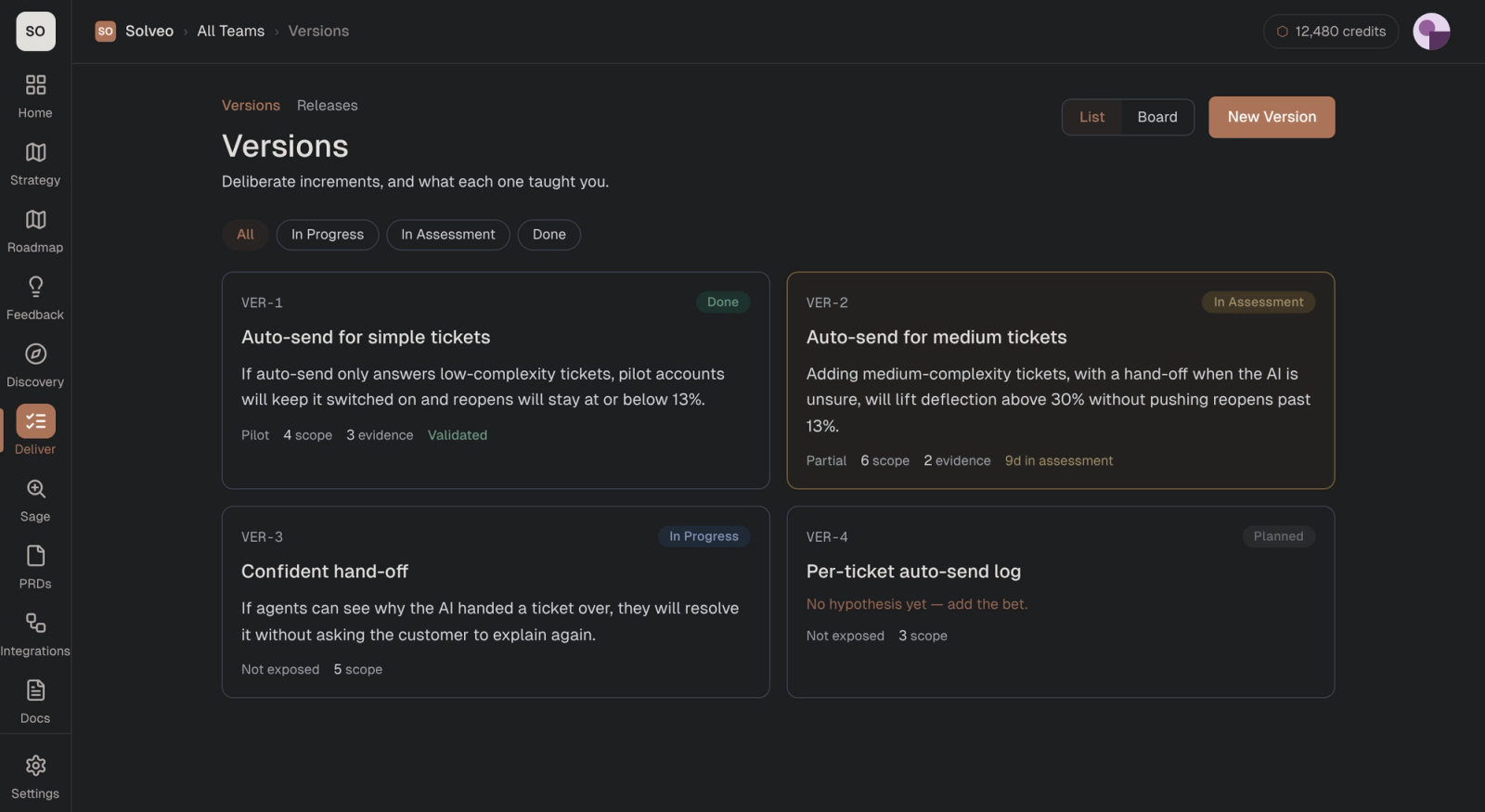

Versions list showing four versions of Solveo's auto-send work, each with its hypothesis, exposure, scope and status.
Each version carries the bet it has to prove.

STEP 02

Ship the first version to a pilot, then record the verdict

VER-1 limited auto-send to low-complexity tickets and went to twelve pilot accounts. Four weeks later the team recorded the verdict, the evidence behind it, what they learned, and the next decision: create the next version.

The evidence sits on the version itself, so anyone can see later why the team moved on.

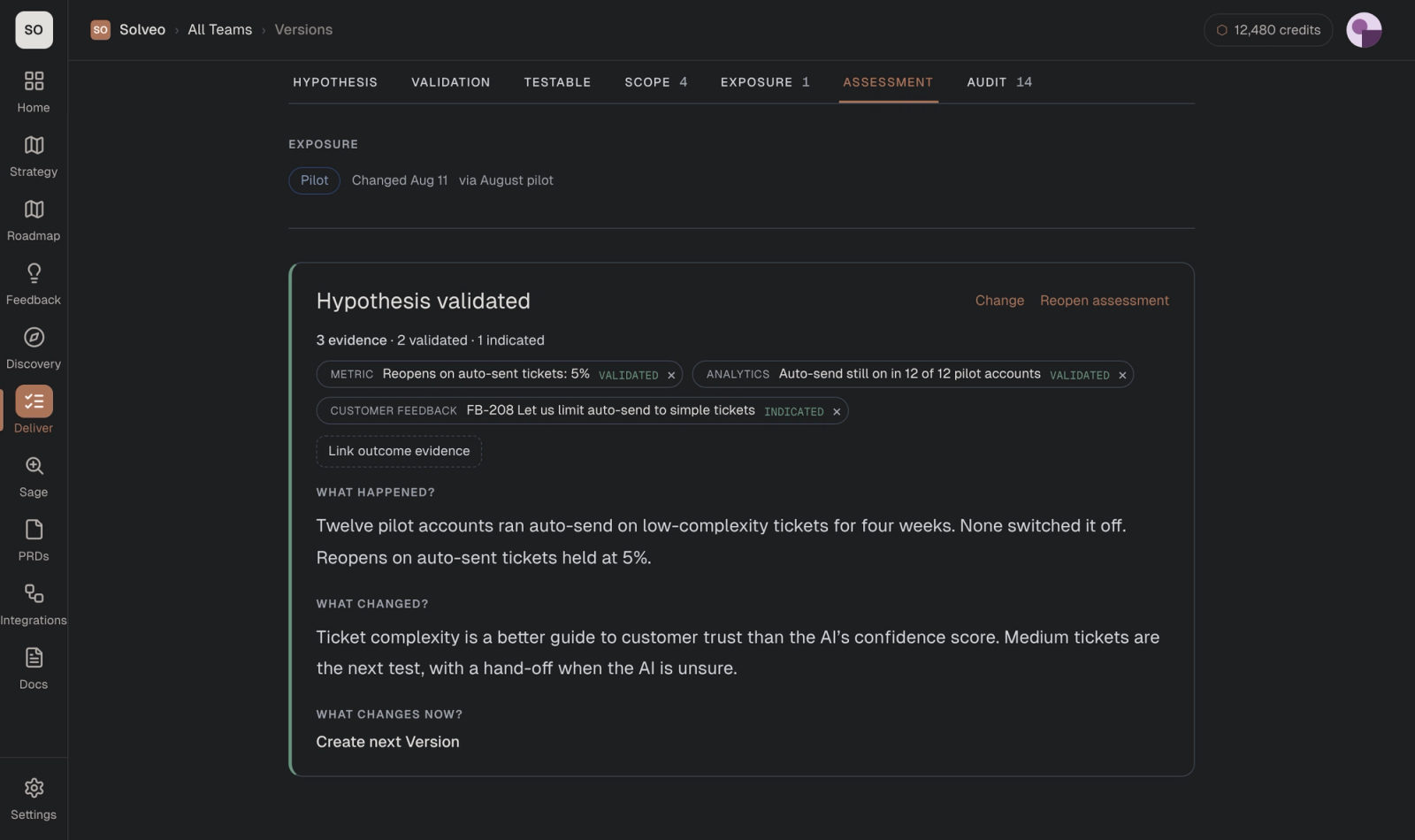

Version VER-1 marked Hypothesis validated, with three linked evidence items and the decision to create the next version.
The verdict, the evidence and the next decision stay on the version.

STEP 03

Build the next version on what the first one taught

VER-2 links back to VER-1 and states its own bet: medium-complexity tickets, with a hand-off to an agent when the AI is unsure.

The team marked the three items needed for a meaningful signal. Assessment could start as soon as those shipped, while the reporting work carried on.

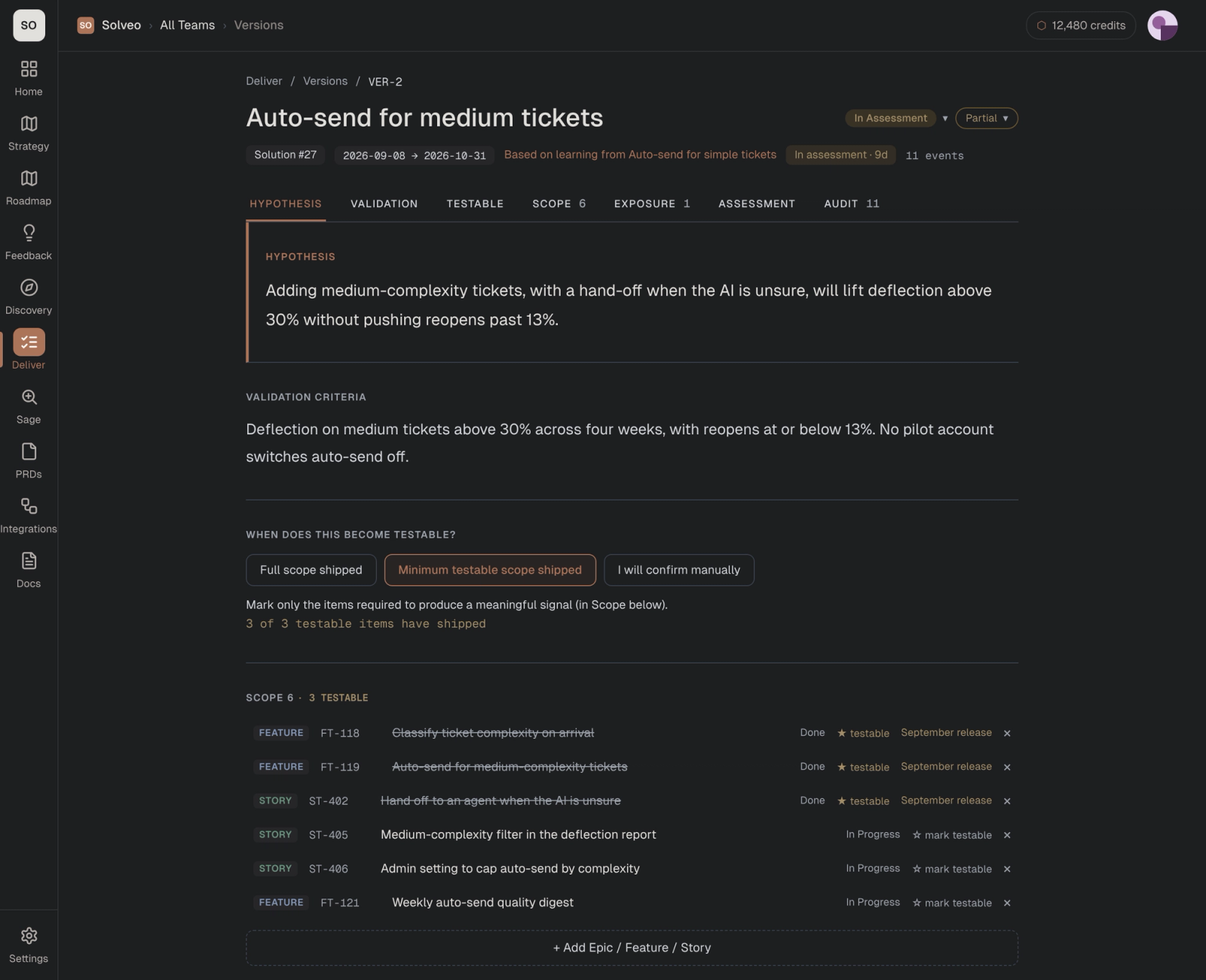

Version VER-2 with its hypothesis, validation criteria, minimum testable scope setting and six scope items, three marked testable.
VER-2 becomes testable once its three marked items ship.

STEP 04

Release what's ready, from any solution

The September release carried VER-2's three testable items. The October release finishes VER-2 and adds the first version of a second solution: showing agents why the AI handed a ticket over.

Tickets and sprint status stay in the team's tracker. The release holds the versions, the launch plan and the links out to flags, analytics and the tracker.

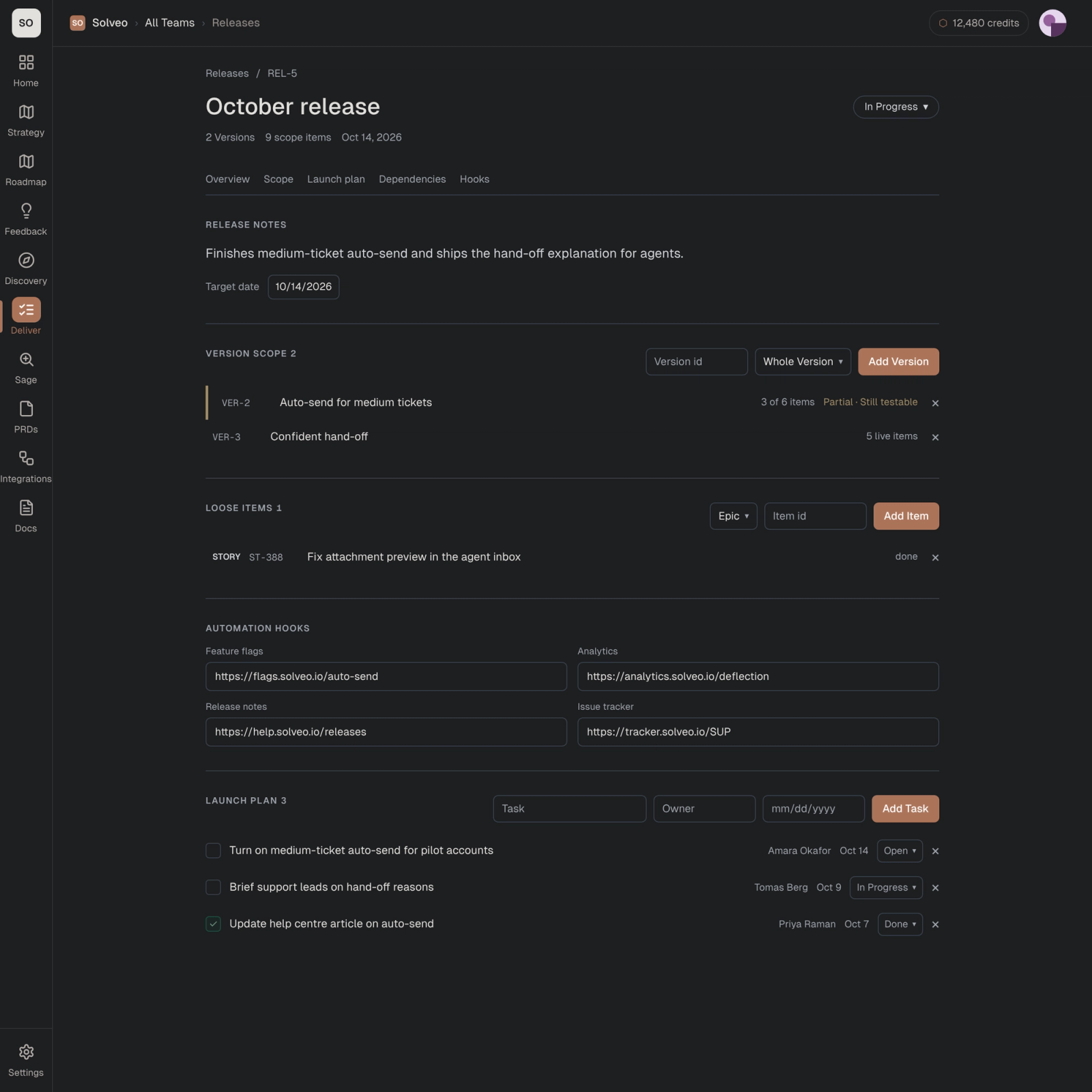

October release containing part of VER-2, all of VER-3 and one loose story, with automation hooks and a launch plan.
One release can carry slices of several versions.

STEP 05

Ask whether the bet held

Nine days after VER-2 became testable, the version asks its own hypothesis back as a question, with the first week's evidence attached. The verdict is the team's call.

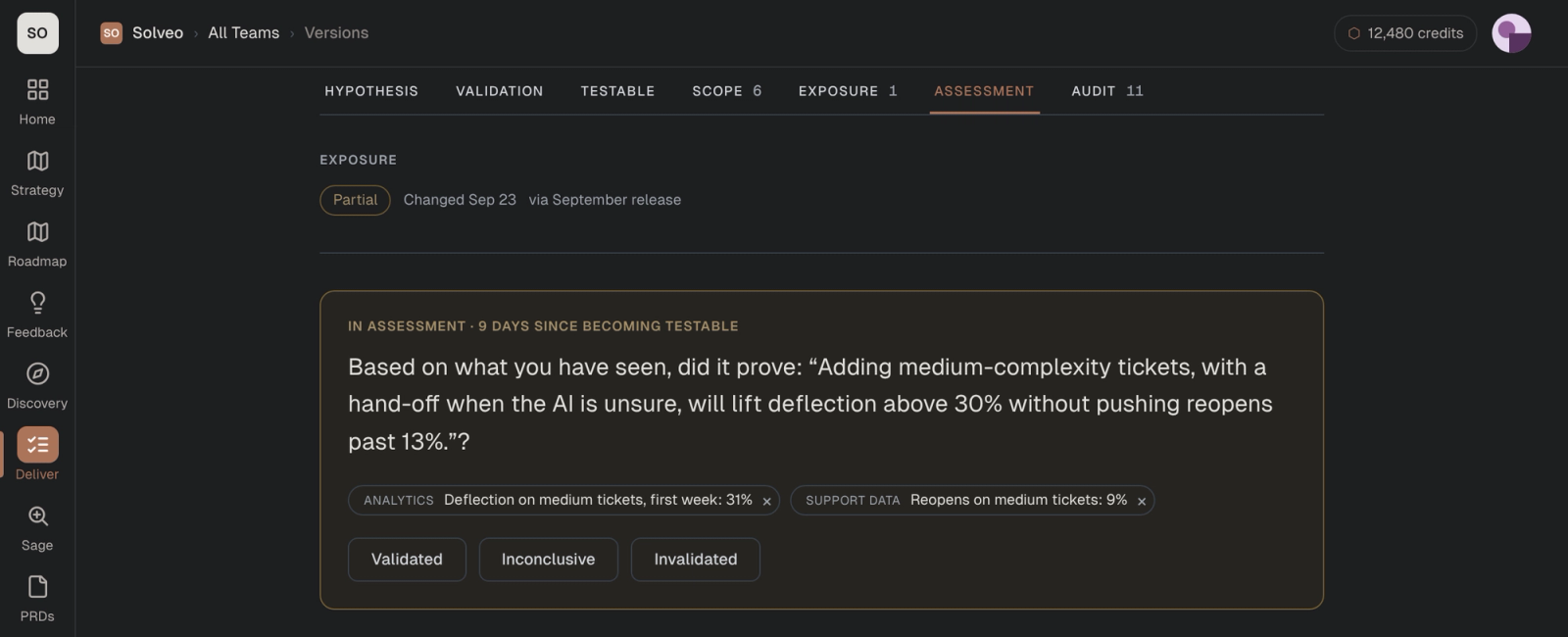

VER-2 in assessment for nine days, asking whether its hypothesis held, with two evidence items and verdict buttons.
After release, the version asks whether the bet held.

Before delivery

Decide what is worth funding before you decide how to deliver it

A backlog mixes different kinds of judgment. One item may look attractive because its expected value is high. Another may be cheap to build. A third may matter because delaying it creates risk.

Shorter Loop keeps value and effort separate instead of hiding both inside one priority number. The score does not make the decision for the team. It makes the reasoning easier to question: why do we expect this much value, how much effort are we committing, and what assumptions sit underneath those estimates?

Make capacity explicit

Put the capacity decision on the page, then question the assumptions behind the winners

Plotting candidate work by value and effort helps the team compare items using the same criteria. A visible cutline then records what the team intends to fund with the capacity available for the period. Work below the line stays visible, along with the reasoning, so it can be revisited when capacity or evidence changes.

The highest-ranked items still need scrutiny. A scoring model can rank its inputs correctly while an important input rests on an unsupported assumption. Before the team commits the work, Shorter Loop keeps that assumption connected to the item so the team can check whether the expected value has enough support.

Then break it down

Break down work after the underlying decision is supported

Once an item has enough support to move forward, the team can break it into features and stories. Shorter Loop keeps the objective, evidence and decision linked to that delivery work while day-to-day status stays in the engineering tracker.

From there, the team decides how to slice the solution into Pilot, Prove, Expand and Mature versions, then combines ready versions into releases.

FAQ

What people ask about versions and releases

Does this replace Jira or Linear?

+

No. Tickets, sprints and day-to-day status stay in your tracker. Shorter Loop holds the versions, the bet each one carries, the releases and the outcomes. Status comes in through the integration.

Do we have to write a hypothesis for every version?

+

It's optional. A version without one shows a reminder on its card, because after release there is nothing to check it against. Sage can draft one from the solution or the opportunity behind it.

When does assessment start?

+

You choose per version: when the full scope ships, when the items you marked as minimum testable ship, or when you confirm it yourself. Shorter Loop counts the days from then and flags versions that have gone too long without an outcome.

Can a release carry only part of a version?

+

Yes. Add a version whole or pick specific items. A partial release is marked either still testable or a deployment step only, so a half-shipped version doesn't start its assessment too early.

What if the result is unclear?

+

Mark it inconclusive and say what you saw. The next decision can be to investigate, continue the rollout, create the next version, stop the solution, or go back to the opportunity.

How long before this is worth anything?

+

It depends on how fast you can connect what you already have. For a ten-person team that has typically taken about five days.

Get Started

Pick one solution you're building and split it into versions.

Write down what the first version has to prove, ship it to a few customers, and record what happened before you build the next one.

This page uses an anonymized customer example. You can open the demo to inspect the versions, release and outcomes shown here.
